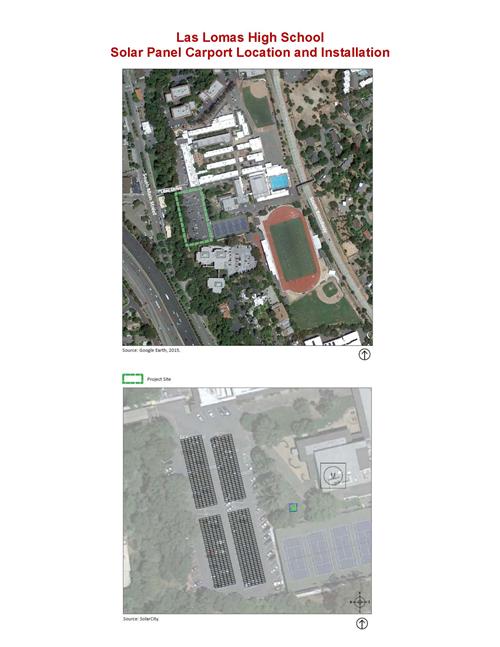

Las Lomas High School Las Lomas High School Solar ProjectSolar Panel Location: Front Parking Lot
Project Timeline:
Site prep and fences up – June 14
Construction begins – June 21
Construction ends – July 18
Fences down – July 19
Punch list and testing – July 20 – July 26
Front Parking Lot Access – None
Facility Use –Very limited
Primarily aquatics and school team use
Parking and drop-off will be in rear of school – from “Whole Foods” entrance
Other Summer Projects –
Science classroom in front of school
