• Miramonte Solar Project
    Miramonte High School Solar Project

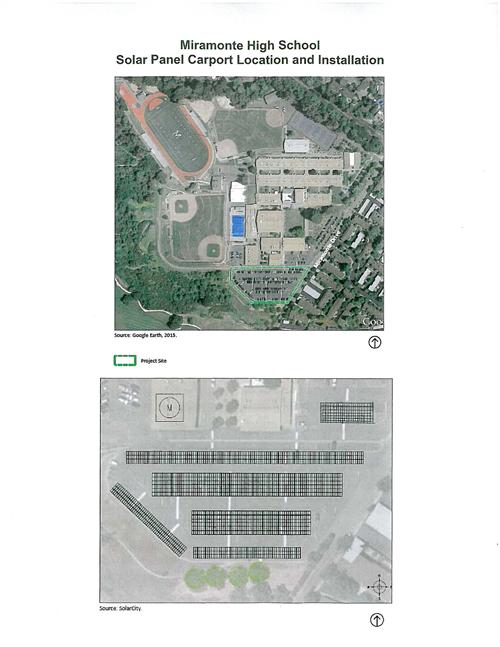

    Solar Panel Location: Rear Parking Lot

    Project Timeline:

    Site prep and fences up – June 27

    Construction begins – July 4

    Construction ends – August 9

    Fences down – August 10

    Punch list and testing – August 11 – August 17

    Rear Parking Lot Access – None

    Facility Use –Very limited

    Primarily aquatics and school team use

    Limited drop-off area will be near the pool area.  There will be very limited parking.

    Other Summer Projects –

    Major plumbing infrastructure project will severely limit use of campus and parking availability.

    MHS
