    Campolindo High School Solar Project

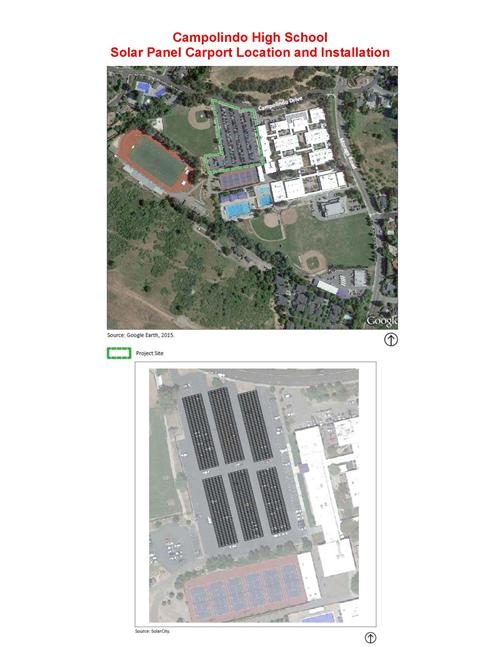

    Solar Panel Location: Rear Parking Lot

    Project Timeline:

    Site prep and fences up – June 13

    Construction begins – June 20

    Construction ends – July 22

    Fences down – July 25

    Punch list and testing – July 26 – August 1

    Rear Parking Lot Access – None

    Facility Use –Very limited

    Primarily aquatics and school team use

    Parking and drop-off will be in front of school – near Performing Arts Center
